Northbound St Kilda Road Service Lanes closed:

  • until 19 December between Lorne and Beatrice Street.

We'll then move to Beatrice Street and Union Street. We're sorry about the disruption and will work as quickly as we can.

Works in and around Albert Park from September 2024

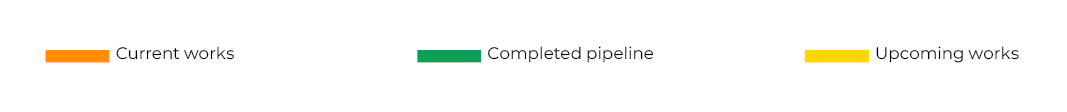

Where we're working

Information for residents and businesses



What we're doing

The project will increase the capacity of the sewer network to cater for population growth in the area and future proof the sewerage system.

We're completing this project in stages and have completed Stage 1 and stage 2a.

Works in Stage 2b at Deakin Street commenced in January 2025. We're starting the final part of works in Deakin and Cowderoy Streets from 18 August until mid November.

We're now in the St Kilda Road Service Lane from Lorne Street to Beatrice Street until 19 December. We'll then move into Beatrice Street, then finish the project in Union Street.

Before installing the new sewer in Union Street, we need to relocate an underground service. This is scheduled for 1-19 December 2025.

There will be no interruption to your water or sewer services while we work.

When it's happening

Construction of the new sewer started in mid September 2024. We expect the project to take approximately 18 months, depending on the weather. We'll keep you updated and notify the surounding area before works commence.

  • Stage 1 - Albert Park (near Ross Gregory Oval)
    September 2024 - January 2025 COMPLETE
  • Stage 2a - Cowderoy Street - COMPLETE
    November 2024
  • Stage 2b - Deakin Street at Canterbury Road
    January 2025 - July 2025
  • Cowderoy Street at Park Street - COMPLETE
    January 2025 - mid November 2025
    Deakin Street at Park Street
    Ongoing
  • Stage 3 - Albert Park (near Hockey Drive)
    April 2025 - August 2025
  • St Kilda Road Service Lane (heading northbound from Union Street to Lorne Street) - COMPLETE
    Mid August - mid November 2025
  • St Kilda Road Service Lane and Beatrice Street (heading northbound from Lorne to Beatrice Streets)
    16 October 2025 - 19 December 2025
  • Union Street
    1 December - 19 December 2025
    Further works in early 2026, pending approvals

We expect to finish the whole project by mid 2026.

Working hours are Monday to Friday between 7am and 6pm. On occasion we may need to work outside these hours for safety, technical or permit reasons.

We may need to work on Saturdays between 9am and 5pm in the future too, depending on our progress. We’ll send nearby residents an SMS or e-mail before any out-of-hours works.

Information for Albert Park users



Access and parking

You'll have access to the park throughout the project, however when we're working nearby you may notice:

  • Traffic detours, including some permanent one way roads.
  • We might have to block off some areas and stop traffic to allow for deliveries, machinery and some work zones. Please adhere to signage on site.
  • Less car parks on Hockey Drive and Village Green Drive.

Extra car parks are being set up near Stuart King Pavillion as we'll need to occupy some parking spaces in Hockey Drive and Village Green Drive.

When we've finished the job, we'll leave things how we found them and return any areas we’ve impacted as close as possible to their original condition.

Bike and Footpaths

Works may impact the Western Bike Path and the footpath opposite. You'll notice temporary fencing for safety of pedestrians and cyclists, as heavy vehicles will be moving in the area. You'll see signage along the bike path to alert cyclists to the changed path conditions ahead and traffic management as required.

Sporting clubs

We're working with clubs to minimise impacts as much as we can. We'll speak to Parks Victoria and each club before works start nearby and discuss their schedule.

Special events

We're working with Parks Victoria to minimise impacts during the project. Before special events, we'll pack up our site as best we can and make the area safe.

What you might hear and see

Frequently Asked Questions

We manage an infrastructure program which involves replacing, maintaining and upgrading the existing water and sewerage infrastructure above and below the ground, so you can always rely on us when you need a drink, a bath, to wash the clothes or dishes and every time you flush or send water down the drain.



There are more of us living in the Albert Park area now and, with potential storm surges, floods and extreme weather events from climate change, we need to make sure everyone is protected from sewage surges or overflows. Sewage surges or overflows happens when flooded sewerage pipes aren’t large enough and don’t have the pressure, to take sewage and additional storm water run-off to the local treatment plant.

We’ve awarded the contract to Zinfra, Jaydo, WSP Joint Venture (ZJW)

South East Water and their appointed contractors will keep you informed about the project and construction in your area, and we’ll work with you to discuss your access needs before we start to build.

The new sewer pipes will be laid beneath the road or footpath, depending on the outcomes of geotechnical investigations and the location of utilities.  The pipes will be laid using trenchless technology, where shafts are dug, then bores are sunk, and pipes pushed through behind them. This is the best way to lay pipes in built up areas because it limits the disruption to the local community.

No, but please don't hesitate to call our 24/7  Faults and Emergencies team on 13 28 12 if you experience disruptions at any time.

Construction hours will be Monday to Friday between 7 am and 5 pm. On the odd occasion we may need to work at other times, including night works, for safety or technical reasons. If we do, we’ll make sure we let you know in advance so you can plan accordingly.

We'll endeavour to make sure your driveway isn’t blocked during construction, but if it is, we’ll let you know beforehand, so you have time to organise alternative parking. But don’t worry. We will be around to help you get out of your driveway in an emergency.

We'll speak with you in the lead up to construction to understand more about your deliveries, waste removal and customer access, and work with you to make sure these are not impacted. If we do need to block your driveway for a short period of time, we’ll work out alternative arrangements with you prior to works commencing.

Prior to construction commencing we’ll be in touch to understand more about your parking arrangements. We do apologise if local parking is impacted but will work to make sure this is for as short a time as possible.

When we’ve finished the job, we’ll leave things how we found them and make sure we return any areas we’ve impacted as close as possible to their original condition.

No. There is no cost to the property or business owner for these works.
